Deliverables Tables
THE DELIVERABLES TABLES ARE CLOSED. IF YOU HAVE CHANGES, PLEASE SEND THEM TO CHARLES OR KRISTINE.
Note: see the end of this document for further information about the information in each of the columns.
Deliverables Table: Completed Items from Period 3
D# | lead | A | AD# | Descrip | Plan | Actual | Status | Nature | DisLev |
---|---|---|---|---|---|---|---|---|---|
111 | JIVE | NA | 1.03 | Annual report (incl. Financial information) to EC 1) | 42 | 42 | 4 | R | PP |
112 | JIVE | NA | 1.04 | Final Report to Board and EC 2) | 42 | 42 | 4 | R | PP |
113 | JIVE | NA | 1.05 | Final Plan for using and disseminating knowledge 3) | 42 | 42 | 4 | R | PP |
114 | JIVE | NA | 1.06 | Implementation of the Gender Action Plan 4) | 42 | 42 | 4 | R | PP |
115 | JIVE | NA | 1.07 | Raising public participation and awareness 5) | 42 | 42 | 4 | R | PU |
200 | JIVE | NA | 1.08 | Month 42 Report (including financial information to EC) 6) | 42 | 42 | 4 | R | PU |
88 | DANTE | NA | 2.05 | EVN-NREN meeting No. 3 (with Madrid meeting) (slides for the EVN NREN meeting are posted on the meeting's website, scroll down to Thu 25 June 2009 for) 7) | 40 | 40 | 4 | R | PP |
89 | DANTE | NA | 2.06 | EVN-NREN representatives present EXPReS networking results at the e-VLBI Science & Technology Workshop ( slides for the EVN NREN meeting are posted on the meeting's website 8) | 40 | 40 | 4 | R | PU |
116 | DANTE | NA | 2.07 | NA2 annual & Final reports 9) 10) | 42 | 42 | 4 | R | PP |
91 | OSO | NA | 3.03 | eVSAG meeting No. 3 11) 12) | 40 | 40 | 4 | R | PP |
94 | OSO/CNIG | NA | 3.04 | e-VLBI Workshop to be held in Madrid workshop website 13) 14) | 40 | 40 | 4 | O | PU |
107 | JIVE | NA | 3.05 | Publication of e-VLBI Workshop proceedings POS online proceedings page 15) 16) | 42 | 42 | 4 | R | PU |
83 | JIVE | NA | 4.06 | e-VLBI Demonstration and attendance at Network events (months 13-24): APAN demonstration, presentations | 24 | 18 | x | O | PU |
117 | JIVE | NA | 4.07 | e-VLBI Demonstration and attendance at network events (months 25-42): TERENA 2008, HRAO e-VLBI inauguration, Effelsberg e-VLBI inauguration, IYA 2009 ( main site, EXPReS sub-page, press release, images and links), presentations | 36 | 30 | x | O | PU |
12 | JIVE | SA | 1.03 | Fast/adaptive scheduling tools 17) Dynamic scheduling of the e-EVN | 36 | 36 | 4 | D | PU |
27 | JBO | SA | 1.04 | eMERLIN VSI interfaces design 18) | 22 | 41 | 4 | P | PU |
36 | JIVE | SA | 1.07 | Monitored information handling modules 19) monitored_information_handling_modules.pdf | 42 | 42 | 4 | D | PU |
45 | JBO | SA | 1.09 | Tests using local Jodrell Bank home e-MERLIN telescope 20) 21) | 22 | 41 | 4 | D | PU |
52 | JBO | SA | 1.14 | Test using remote e-MERLIN telescope 22) 23) | 24 | 41 | 4 | D | PU |
53 | JIVE | SA | 1.16 | VSI support software 24) Gzipped tarfile of modified SU control code, Controlling the Mark5B playback unit from JCCS, Domino: Mark5B control software | 28 | 38 | 4 | D | PU |
85 | JBO | SA | 1.19 | Multiple e-MERLIN telescope tests 25) | 24 | 41 | 4 | D | PU |
95 | o/s | SA | 1.20 | Improved network applications 26) tarball of locally developed Mark5 control code jive5a history and download page packet and/or channel dropping | 27 | 30 | 4 | D | PU |
126 | JIVE | SA | 1.23 | Use of WSRT synthesis data for e-VLBI calibration | 17 | 22 | 4 | R | PU |
127 | o/s | SA | 1.24 | Mark5A code modifications 27) OS and application upgrade, from Debian Sarge to Debian Etch with SDK8.1 jive5a history and download page | 27 | 30 | 4 | ||
128 | o/s | SA | 1.25 | Mark5B code modifications 28) tarball of locally developed Mark5 control code Domino: Mark5B control software | 27 | 31 | 4 | ||
151 29) | JIVE | SA | 1.28 | On-the-fly fringe fitting On-the-fly clock searching | 28 | 28 | 4 | ||
152 | JIVE | SA | 1.29 | Real-time download and extraction of station information Monitoring the EVN via Field System logfiles | 30 | 32 | 4 | ||
156 | JIVE | SA | 1.30 | Automated correlator diagnostics Automatic diagonal weight detection, Automatic correlator diagnostics | 33 | 41 | 4 | ||
162 | JIVE | SA | 1.32 | Enhancements & additions to real-time pipeline 30) Enhancements to the easyJIVE web-driven post-processor tool | 42 | 42 | 4 | ||
163 | JIVE | SA | 1.33 | Enhancements & additions to existing monitoring tools 31) Extensions to the Data Status Monitor tool | 42 | 41 | 4 | ||
166 32) | JIVE | SA | 1.34 | Mixed-mode operations Tarball of locally developed Mark5 control code Mixed-mode operations | 38 | 35 | 4 | ||
167 | JIVE | SA | 1.35 | 1024 Mbps e-VLBI and beyond Throughput plot of e-VLBI run on October 19 2008, with the Effelsberg, Jodrell Bank and Westerbork radio telescopes transmitting data at a full 1024 Mbps, e-VLBI beyond the 1Gb/s speedbump, Metsahovi four-Gbps data recorder for VLBI and eVLBI , iBob data acquisition and network streaming | 40 | 36 | 4 | ||
129 | HRAO | SA | 2.06 | Feasibility study of the last-mile connection to the nearest NREN node for participant HRAO 33) 34) | 18 | 20 | x | R | PU |
130 | MERLIN,JIVE | SA | 2.14 | 10 Gbps link upgrade between MERLIN and JIVE 35) | 18 | 41 | 4 | O | PU |
57 | ShAO | SA | 2.16 | Construction and equipment of the last-mile infrastructure for participant Shanghai 36) test 1 APAN demo | 21 | 21 | 4 | O | PU |
59 | ShAO | SA | 2.18 | Construction and equipment of the last-mile infrastructure for participant Urumqi 37) 38) | 21 | 34 | 4 | O | PU |
133 | VIRAC | SA | 2.21 | Construction and equipment of the last-mile infrastructure for participant VIRAC pdf odt | 18 | 31 | 4 | O | PU |
63 | NAIC | SA | 2.22 | Equipment of the last-mile infrastructure for participant NAIC 39) 40) 41) | 24 | 28 | 4 | O | PU |
134 | TIGO | SA | 2.23 | Construction and equipment of the last-mile infrastructure for participant TIGO 42) | 18 | 28 | 4 | O | PU |
69 | INAF | SA | 2.25 | Feasibility study of the last-mile connection to the nearest GÉANT node for participant INAF (Sardinia) | 20 | 20 | x | R | PU |
70 | UniMan,OSO | SA | 2.26 | 10 Gbps link between UniMan and OSO for ultra-VLBI tests | 20 | 41 | 4 | O | PU |
72 | MPIfR | SA | 2.27 | e-VLBI test observations, Effelsberg PDF EVN Newsletter item 1 item 2 | 21 | 25 | 4 | R | PU |
74 | OAN | SA | 2.29 | e-VLBI test observations, Yebes | 22 | 38 | 4 | R | PU |
86 | HRAO | SA | 2.30 | Construction and equipment of the last-mile infrastructure for participant HartRAO APAN test observations | 27 | 27 | 4 | O | PU |
97 | ShAO | SA | 2.31 | e-VLBI test observations, Urumqi announcement 43) | 33 | 34 | 4 | R | PU |

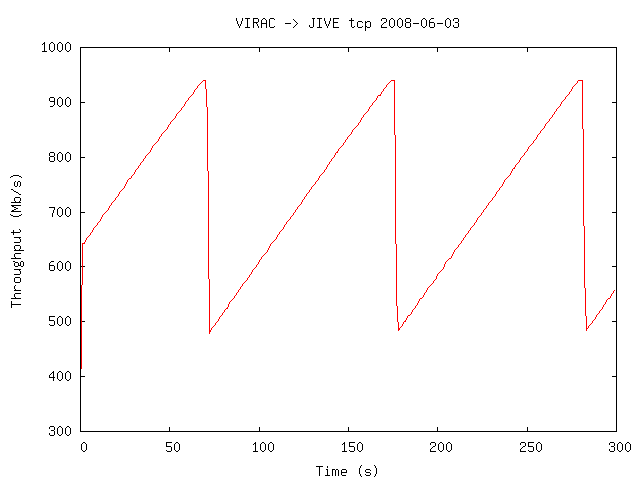

153 | VIRAC | SA | 2.34 | e-VLBI test observations, VIRAC (short document regarding VIRAC's inability participate in e-VLBI, Status of Irbene site in e-VLBI) | 33 | 42 | 4 | R | PU |
101 | HRAO | SA | 2.35 | e-VLBI test observations, HRAO press release, EVN Tech Announcement, EVN Newsletter announcement , two fringe plots | 30 | 27 | 4 | R | PU |
102 | NAIC | SA | 2.36 | e-VLBI test observations, NAIC, Arecibo. Public announcement on web site | 30 | 28 | 4 | R | PU |
154 | TIGO | SA | 2.37 | e-VLBI test observations, TIGO. REUNA Announcement | 33 | 28 | 4 | R | PU |
155 | INAF | SA | 2.38 | Construction and equipment of the last-mile infrastructure for participant INAF (Sardinia) Email Announcement, new Italian network map | 30 | 35 | 4 | O | PU |
78 | OSO | J | 1.02 | Overall broadband demonstration 44) | 40 | 41 | 4 | D | PU |
139 | JIVE | J | 1.03 | Visualization software 45) description visualisation software 46) | 38 | 42 | 4 | P | PU |
150 | JBO | J | 1.11b | Final Protocols performance report | 30 | 36 | 4 | ||
43 | JIVE | J | 1.13 | Software data product document 47) | 17 | 35 | 4 | P | PU |
66 | MPIfR | J | 1.14 | Data acquisition interface document 48) | 29 | 40 | 4 | R | PU |
67 | ASTRON | J | 1.15 | LOFAR station interface report- partial report complete report, informal form 49) | 21 | 35 | 4 | R | PU |
68 | PSNC | J | 1.16 | Software for workflow management ( early document, 2009 Jan documentation update). tgz'd Code drops ( drop #1, drop #2). 50). Additional documentation and integration report. | 18 | 34 | 4 | P | PU |
76 | MPIfR | J | | | | 4 | R | PU | |
77 | MRO/OSO | J | 1.19 | Data acquisition prototype at telescope report EVN News announcement 53) | 26 | 28 | 4 | P | PU |
79 | JIVE | J | 1.21 | Software cluster correlation (sfxc-0.0.6_deliverable_2_2_3.tar.gz, First fringes announcement) code drop 2 for 2009-jan. Final e-VLBI System Report (pdf) and final documentation package (tgz) (note, this is a comprehensive, HTML-based documentation of the libraries used on the software. Additional documentation is in the software itself) | 23 | 35 | 4 | P | PU |
87 | JIVE | J | 1.23 | Software to collect distributed output 54) PSNC report, Webservices Report and code drop | 32 | 37 | 4 | P | PU |
92 | JIVE | J | 1.24 | Software to create data product from distributed correlation 55) | 31 | 26 | 4 | P | PU |
93 | PSNC | J | 1.25 | Software routing (contained as part of tgz'd code drop #2). Additional documentation and integration report. | 29 | 34 | 4 | P | PU |
105 | JBO | J | 1.26 | eMERLIN interface available 56) | 30 | 35 | 4 | P | PU |
106 | JIVE | J | 1.27 | Fringes with new routing PDF 57) 58) 59) | 40 | 37 | 4 | D | PU |
108 | JIVE | J | 1.28 | Software distributed correlation | 33 | 36 | 4 | P | PU |
109 | JIVE | J | 1.29 | First fringes Grid correlator, and the PSNC report 60) 61) correlator software62) | 40 | 39 | 4 | D | PU |
110 | JIVE | J | 1.30 | First fringes on FABRIC | 35 | 35 | 4 | D | PU |
118 | JIVE | J | 1.31 | Final report 63) | 42 | 42 | 4 | R | PU |
76a | MPIfR | J | 1.32 | Data acquisition interface report (complete, deliverable combined with report for D66 “ Data acquisition interface”) | 36 | 40 | 4 | ||
76b 64) | MRO/OSO | J | 1.33 | Data acquisition interface report | 36 | 32 | 4 |
Deliverables Table: Completed Items from Period 2
NOTE: The deliverables for Period 2 have been separated from the rest of the project to make the above table a bit smaller and easier to read.
NOTE: See the table above for deliverables from Period 2 to the end of the project.
D# | lead | A | AD# | Description | Plan | Actual | Status | Nature | DisLev |
---|---|---|---|---|---|---|---|---|---|
123 | JIVE | J | 1.04 | Correlator design specification | 13 | 16 | 4 | ||
122 | JBO | J | 1.11a | Interim Protocols performance report 65) | 13 | 15 | 4 | ||
42 | JIVE | J | 1.12 | Software correlator core | 15 | 6 | 4 | P | PU |
46 | OSO | NA | 3.02 | eVSAG meeting No. 2 | 16 | 15 | 4 | R | PP |
11 | JIVE | SA | 1.02 | Job preparation utilities | 16 | 16 | 4 | D | PU |
28 | SA1 | SA | 1.05 | Network Protocol decision: A Simulation model for e-VLBI traffic on network links in the Netherlands,Comparing Simulation and Network Monitoring Results, On Network Monitoring of end-to-end paths used for e-VLBI, UDP-like TCP | 16 | 20 | 4 | D | PU |
124 | JIVE | SA | 1.22 | Mark5 hardware upgrade | 16 | 20 | 4 | O | PU |
125 | JIVE | J | 1.05 | Overall design document | 17 | 23 | 4 | ||
48 | DANTE | NA | 2.03 | EVN-NREN meeting No. 2 | 18 | 20 | 4 | R | PP |
49 | JBO/JIVE | NA | 4.05 | Generation of new PR material (phase 2: display stand and merchandise) | 18 | 23 | 4 | O | PU |
51 | JIVE | SA | 1.13 | Tested software for operational improvements | 18 | 18 | 4 | D | PU |
71 | JIVE | SA | 1.17 | Flexible local GE network 66) | 18 | 19 | 4 | D | PU |
131 | MRO | SA | 2.15 | e-VLBI test observations, Metsahovi: quick report from month 13, MRO Test Observations | 18 | 13 | 4 | R | PU |
132 | AARNET, CSIRO | SA | 2.17 | Construction and equipment of the last-mile infrastructure in AARNET to allow connection of participant CSIRO | 18 | 18 | 4 | O | PU |
135 | AARNET | SA | 2.24 | AARNET connectivity enhancements EVN Newsletter announcement | 18 | 18 | 4 | O | PU |
136 | JIVE | SA | 1.26 | Investigating a 1024M sub-array | 20 | 23 | 4 | R | PU |
73 | MRO, CSIRO | SA | 2.28 | e-VLBI test observations, Metsahovi | 22 | 20 | 4 | R | PU |
75 | JIVE | J | 1.17 | Software for correlation on cluster 67) | 23 | 23 | 4 | P | PU |
80 | JIVE | J | 1.22 | First fringes software correlator | 23 | 15 | 4 | D | PU |
54 | JIVE | SA | 1.15 | VSI Interfaces 68) | 23 | 16 | 4 | D | PU |
81 | JIVE | NA | 1.02 | Annual report (incl. Financial information) to EC | 24 | 24 | 4 | R | PP |
148 | JIVE | SA | 1.27 | Space craft tracking correlator mode | 27 | 20 | 4 | R | PU |
84 | JIVE | SA | 1.18 | Network monitoring tools Lightpath status monitoring69) | 30 | 24 | 4 | D | PU |
96 | SA1 | SA | 1.21 | Monitoring user interfaces | 30 | 7 | 4 | D | PU |
161 | JIVE | SA | 1.31 | Removing/adding stations from the correlation process on the fly | 34 | 20 | 4 | R | PU |
31 | DANTE | NA | 2.04 | NA2 annual report No. 2 (as part of EXPReS Ann. Rep) | 24 | 24 | 4 | R | PP |
| | | | | 33 | 4 | R | PU | |
| | | | | 33 | 4 | R | PU | |
| | | | | | 4 | | |
|
| | | | | | 4 | | |
Deliverables Table: Completed Items from Period 1
NOTE: The deliverables for Period 1 have been separated from the rest of the project to make the above table a bit smaller and easier to read.
NOTE: See the table above for deliverables from Period 2 to the end of the project.
D# | lead | A | AD# | Description | Plan | Actual | Status | Nature | DisLev |
---|---|---|---|---|---|---|---|---|---|
2 | JRA1 | J | 1.01 | Data acquisition requirements document | 2 | 3 | 4 | R | PU |
3 | JRA1 | J | 1.02 | Protocols strategic document | 2 | 2 | 4 | R | PU |
1 | NA4 | NA | 4.01 | Creation of Public EXPReS web-site | 2 | 1 | 4 | O | PU |
4 | DANTE | NA | 2.01 | EVN-NREN meeting No. 1 (under auspices of EXPReS) (minutes) | 3 | 6 | 4 | R | PP |
5 | SA1 | SA | 1.01 | Central data link control, Correlator Control Code modifications (not documented) | 3 | 7 | 4 | D | PU |
6 | OSO | NA | 3.01 | First meeting of eVSAG under auspices of EXPReS (minutes) | 4 | 9 | 4 | R | PP |
7 | NA4 | NA | 4.02 | Creation of EXPReS web-based management tools | 4 | 4 | 4 | O | PP |
23 | JRA1 | J | 1.06 | eVLBI-Grid design document | 6 | 9 | 4 | R | PU |
10 | NA4 | NA | 4.03 | Generation of PR material (phase 1: logos and posters, PowerPoint template, press releases and news clippings, brochure) | 6 | 1 | x | O | PU |
13 | SA2 | SA | 2.01 | Feasibility study of the last-mile connection to the nearest NREN node for participant CNIG-IGN | 6 | 9 | 4 | R | PU |
14 | SA2 | SA | 2.02 | Feasibility study of the last-mile connection to the nearest NREN node for participant MPIfR | 6 | 9 | 4 | R | PU |
15 | SA2 | SA | 2.03 | Equipment of the last-mile infrastructure for participant INAF (telescope in Medicina) | 6 | 9 | 4 | O | PU |
16 | SA2 | SA | 2.04 | Feasibility study of the last-mile connections to the nearest GEANT NREN node for participant CAS (Shanghai, Urumqi, Miyun, Yunnan ) | 6 | 9 | 4 | R | PU |
17 | SA2 | SA | 2.05 | Feasibility study of the last-mile connection to the nearest NREN node for participant VIRAC | 6 | 9 | 4 | R | PU |
19 | SA2 | SA | 2.07 | Feasibility study of the last-mile connection to the nearest NREN node for participant NAIC (Arecibo) | 6 | 9 | 4 | R | PU |
20 | SA2 | SA | 2.08 | Feasibility study of the last-mile connection to the nearest NREN node for participant TIGO | 6 | 9 | 4 | R | PU |
21 | SA2 | SA | 2.09 | Feasibility study of the last-mile connection to AARNET for participant CSIRO | 6 | 9 | 4 | R | PU |
24 | JRA1 | J | 1.07 | eVLBI fringes PC-EVN (Month 7 Demo report) | 7 | 7 | 4 | D | PU |
25 | JRA1 | J | 1.08 | LOFAR connection strategic document | 7 | 11 | 4 | R | PU |
26 | JRA1 | J | 1.09 | Data acquisition design document | 8 | 11 | 4 | R | PU |
35 | JIVE | SA | 1.06 | Selective data processor controls | 9 | 9 | 4 | D | PU |
30 | JRA1 | J | 1.10 | eVLBI-Grid interface document | 10 | 10 | 4 | R | PU |
29 | SA2 | SA | 2.10 | e-VLBI test observations, Medicina (256 Mbps fringes) (science announcement) | 10 | 3 | 4 | R | PU |
32 | JIVE | NA | 1.01 | Annual report (incl. Financial information) to EC 74) | 12 | 13 | 4 | R | PP |
33 | DANTE | NA | 2.02 | NA2 annual report No. 1 (as part of EXPReS Ann. Rep No. 1) 75) | 12 | 13 | 4 | R | PP |
34 | NA4 | NA | 4.04 | e-VLBI Demonstration and attendance at Network events (events, presentations) | 12 | 12 | x | O | PU |
40 | SA1 | SA | 1.08 | Monitoring processes | 12 | 7 | 4 | D | PU |
44 | SA1 | SA | 1.10 | Real-time data processor control software (no document) | 15 | 4 | 4 | P | PU |
37 | MRO | SA | 2.11 | Equipment of the last-mile infrastructure for participant MRO | 12 | 5 | 4 | O | PU |
38 | CNIG-IGN | SA | 2.12 | Construction and equipment of the last-mile infrastructure for participant CNIG-IGN ( Feasibility study ) | 12 | 15 | 4 | O | PU |
39 | MPIfR | SA | 2.13 | Construction and equipment of the last-mile infrastructure for participant MPIfR ( Feasibility study Announcement) | 12 | 15 | 4 | O | PU |
47 | SA1 | SA | 1.11 | Real-time Pipeline | 16 | 9 | 4 | D | PU |
50 | SA1 | SA | 1.12 | Visibility monitor | 18 | 4 | 4 | D | PU |
Legend for table headings
D# == Deliverable # Actual == Actual Delivery Month \\ A == Activity Status == Current Status ( x of 4 ) \\ AD# == Activity Specific Deliverable Number Nature == Nature \\ Descrip == Deliverable description DisLev == Dissemination Level \\ Plan == Planned Delivery Month \\
Notes on Columns
“Status”
The status of the deliverable on a 0 to 4 scale. x = Ongoing effort 4 = Deliverable completed and presented to Project Manager 3 = Deliverable in draft form 2 = Most work completed 1 = Some work started 0 = No work started --> = Deliverable has been identified as actively delayed
“Nature”
R = Report P = Prototype D = Demonstrator O = Other
“Dissemination Level”
PU = Public PP = Restricted to other programme participants (including the Commission Services). RE = Restricted to a group specified by the consortium (including the Commission Services). CO = Confidential, only for members of the consortium (including the Commission Services).
“Removed deliverbales”
deliverables that have been officially removed are indicated with <del>strikethrough text</del>. Officially removed is determined by removal from the DOW as submitted to the EC.
1)
, 2)
, 3)
, 4)
, 5)
, 6)
, 10)
, 63)
note: deliverables associated with the final report are being marked as complete prior to their actual delivery to the Commission
11)
Meeting held 18:30 – 20:30 Monday 22 June 2009 per the published, online agenda
12)
was 26, now tied to with Madrid meeting
13)
location of meeting changed to Madrid from Onsala
14)
was 37
15)
note: this will be done via the project office. The responsible party is also being switched from OSO to JIVE to better reflect the change in responsibility.
16)
note: this activity is effectively complete, pending edits from one author
18)
orig 9
19)
orig 12
20)
orig 15
29)
note: in the 18 month report, this is incorrectly labeled as D148
31)
was 26
32)
in the 18 month report, this is incorrectly labeled as D164
34)
due to a serious mechanical failure, future participation from HartRAO is unlikely within the remaining timeframe of the project. The work completed to date will be included in the SA2 report, but additional work will be minimal as they concentrate on repairs at their telescope.
35)
this deliverable was marked as ongoing in month 20. A final report was provided at the end of the project to summarize the activities. The completion date has been moved to month 41 (from 20) and the status is now 4/done (from x).
38)
this is done, xref the test results for deliv 2.31
40)
note: infrastructure is in place and test schedule is being determined. All expect that the new connectivity will pass tests without much effort.
41)
Announcement that Arecibo is back and participating.
42)
this is done, xref deliverable 2.37
45)
orig 4
46)
note: complete software correlator source code, shared with deliverable 109
47)
There is a version that works with the correlator core delivered with "D42 Software correlator core. The software itself will continue to evolve to keep up with developments in the correlator, so true completion will be at the end of the project.
50)
Core functionality in place. Optimization in progress and will be delivered in the final code drop
52)
note: this was split into two new deliverables. see the pair of deliverables titled Data acquisition interface report at J1.32 and J1.33
55)
The software tool is integrated into the standard procedure for observations. It is considered complete, but is also an evolving piece of software. Note that this is an internal tool, used by the correlator operators. Documentation is provided via the help flag and internal documents.
57)
orig 31
58)
note: suggest combining this with D109 - J 1.29
59)
note: final document is complete and covers multiple deliverables. The PSNC report covers this content and that work was documented in the PSNC report presented to the project.
60)
note: individual pieces- software correlator and worlflow manager- are done and now integration and testing of the overall grid correlator is needed. Plans for an intensive, co-located development push are underway to complete this item. Note, intensive face to face completed, document from that work submitted to project.
61)
note: final document is complete and covers multiple deliverables. The PSNC report covers this content and that work was documented in the PSNC report presented to the project.
62)
note: includes visualisation software, shared with deliverable 139
64)
note: should have been 165, but lettered deliverable option was used
65)
comments on this draft are very much appreciated by the authors
66)
orig 21
67)
note: this links to a tar file as the deliverable
